India is Wasting the Sun.
India's grid operators spent the year "switching off and wasting" — solar and wind power that the system simply could not absorb.
India has become genuinely world-class at building solar and wind farms. We added a record 38 GW of solar last year alone. Renewable sources now make up 50% of our installed power capacity — a target that was supposed to arrive in 2030, hit five years early. Every minister cites this number. Every investor deck opens with it.

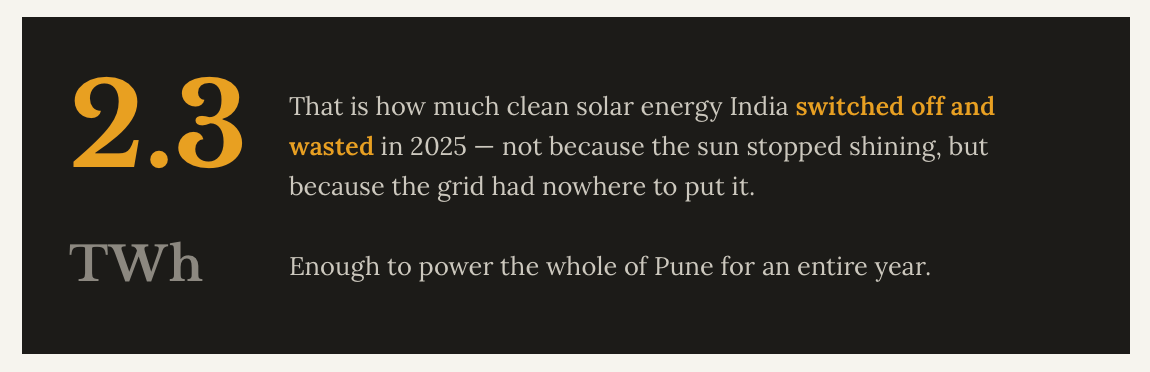

However in 2025 India’s grid operators spent the year curtailing — that is the technical word for “switching off and wasting” — solar and wind power that the system simply could not absorb. Too much clean energy, generated in the wrong places, at the wrong times, with nowhere to go.
Three Mismatches, One Crisis
To understand why India is wasting its own sunshine, you need to know one fundamental thing about electricity: it cannot be stockpiled. The moment it is generated, it must be consumed — or it is gone. The grid must be in perfect balance, every second of every day, between supply and demand.
India currently has three problems that violate this balance simultaneously.

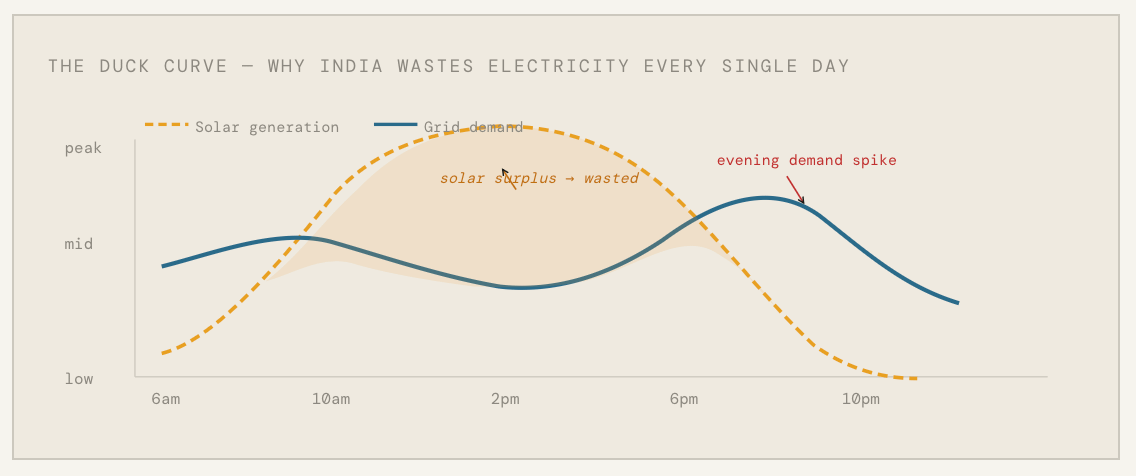

The time mismatch. Solar panels produce their peak output between 10am and 4pm, when offices and factories are humming along at moderate load. But India’s electricity demand peaks between 6pm and 10pm — when millions of ACs, fans, and appliances turn on simultaneously. There is a six-hour gap between when clean power is abundant and when people actually need it. Without storage to bridge this window, grid operators have no choice but to switch off the excess solar. It is called curtailment. It is, for want of a better word, a tragedy.
The geography mismatch. Rajasthan and Gujarat are India’s renewable energy super-producers — the equivalent of a Saudi Arabia for solar. But they are not where most Indians live or work. Maharashtra, Uttar Pradesh, Tamil Nadu: these states need the electrons, but the transmission corridors to move power there are badly undersized. So the solar-rich states sit with surplus power they cannot sell, while the demand-heavy states quietly keep burning coal.
The speed mismatch. A solar farm can be fully commissioned in 18 months. A new transmission corridor — with land acquisition battles, forest clearances, rights-of-way across multiple state boundaries, and complex high-voltage engineering — takes three to six years. The grid infrastructure is structurally, chronically behind the generation curve. Nobody has found a way to fast-forward a forest clearance.
A 250-Times Gap — and a ₹9 Lakh Crore Fix
India needs 230+ gigawatt-hours of grid-scale battery storage by 2030. As of today, we have less than 1 GWh installed. The gap is roughly 250 times what currently exists.
To calibrate that against something real: the entire world had roughly 300 GWh of grid-scale battery storage installed at the end of 2024. India alone needs to add 230 GWh more in six years. This is one of the largest infrastructure build programmes any country has attempted in the history of the clean energy transition. Two major problems exist
India’s power system was built around steady coal plants that produced cheap electricity and quietly kept the grid stable. But as solar and wind energy rapidly expand, balancing the grid becomes harder because renewable power is intermittent. Battery Energy Storage Systems (BESS) can respond much faster than coal plants, but they require separate payments for grid-support services. Many DISCOMs resist these extra costs today, but as India moves toward 500 GW of renewables, battery storage will become essential for reliable and affordable electricity supply.
India is adding renewable energy rapidly, but transmission lines needed to carry this power face major delays from land disputes and forest clearances. Projects that need only two years to build often take five or more years for approvals. The government is improving coordination, but faster clearance systems may become essential.
What Actually Solves This
The fix has two components, and both need to happen simultaneously or neither works fully.
Storage — making electricity wait
Battery storage (BESS) is the most immediate lever. A battery farm co-located with a solar park charges during the midday surplus and discharges into the evening peak. No new transmission lines needed, no land disputes, just a large lithium iron phosphate battery sitting next to the panels.
Pumped hydro storage is India’s underutilised long-duration weapon. Pump water uphill when power is surplus. Release it through turbines when demand spikes. Essentially a mountain-sized rechargeable lake, with a lifespan of 50+ years and no battery degradation. India has identified 96 GW of pumped hydro potential but only 6 GW is operational.
Transmission — making electricity travel farther
HVDC superhighways carry power over 1,000+ km with dramatically lower losses than conventional lines. The Ladakh GEC-II project — a ₹20,773 crore HVDC corridor due by 2030 — will unlock 13 GW of Himalayan renewable energy for the national grid.
Smart grids and demand flexibility offer the quickest win. AI-powered grid management can optimise dispatch and reduce curtailment by 5–10% on existing infrastructure. Meanwhile, Time-of-Day electricity tariffs (already mandated for large commercial consumers) incentivise factories and data centres to shift load to midday — effectively “absorbing” solar surplus without building a single new battery or wire.
Who Builds the New Grid

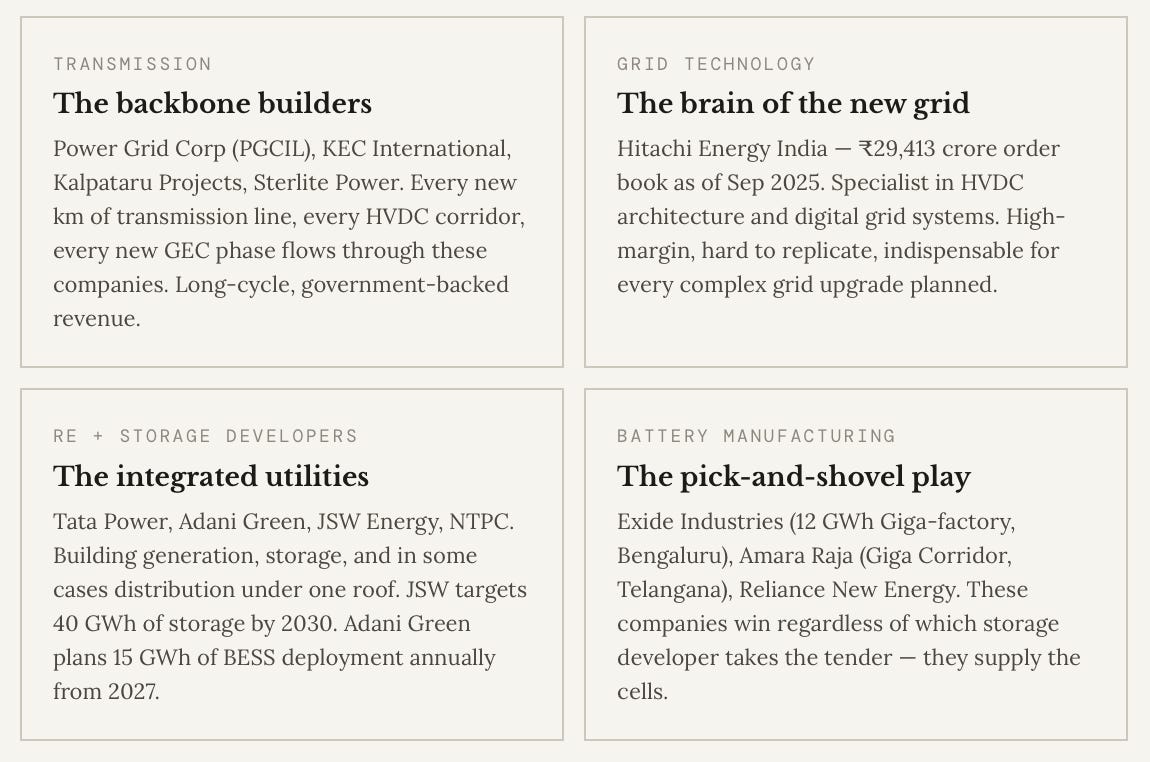

Four categories of companies sit at the structural heart of this buildout. Each benefits from a different part of the value chain — and each has a different risk profile.
Conclusion
A grid that can absorb 500 GW of renewable power is not simply an environmental achievement. It is the physical infrastructure of India’s next phase of economic growth.
Cheap, reliable, clean electricity determines where factories locate. It determines whether Indian manufacturing can compete on cost with Vietnam and Bangladesh. It determines whether the global wave of data centre investment — which needs 24x7 carbon-free power and is currently flooding India — stays and grows or routes around us. It determines whether the next twenty years of growth are inflationary or not, given how much of India’s current import bill is fossil fuel.
Solving grid absorption is not a niche infrastructure fix. It is the precondition for the middle-income Indian economy that everyone is projecting but nobody has fully paid for yet.
